FEATURED
SAVE THE SHORE
Manasquan’s borough-wide flood plan — nine phases, now in design and under State review.
Explore the planFEATURED
MAIN STREET
A menu of ideas for our downtown — take a look and tell us what you think.
Take a lookHAPPENING NOW:
Projects A–Z
Project Schedule
as of October 19, 2026Design
Bidding / Award
Permitting / Approval
Pre-Construction
Construction
Seasonal Shutdown
Today

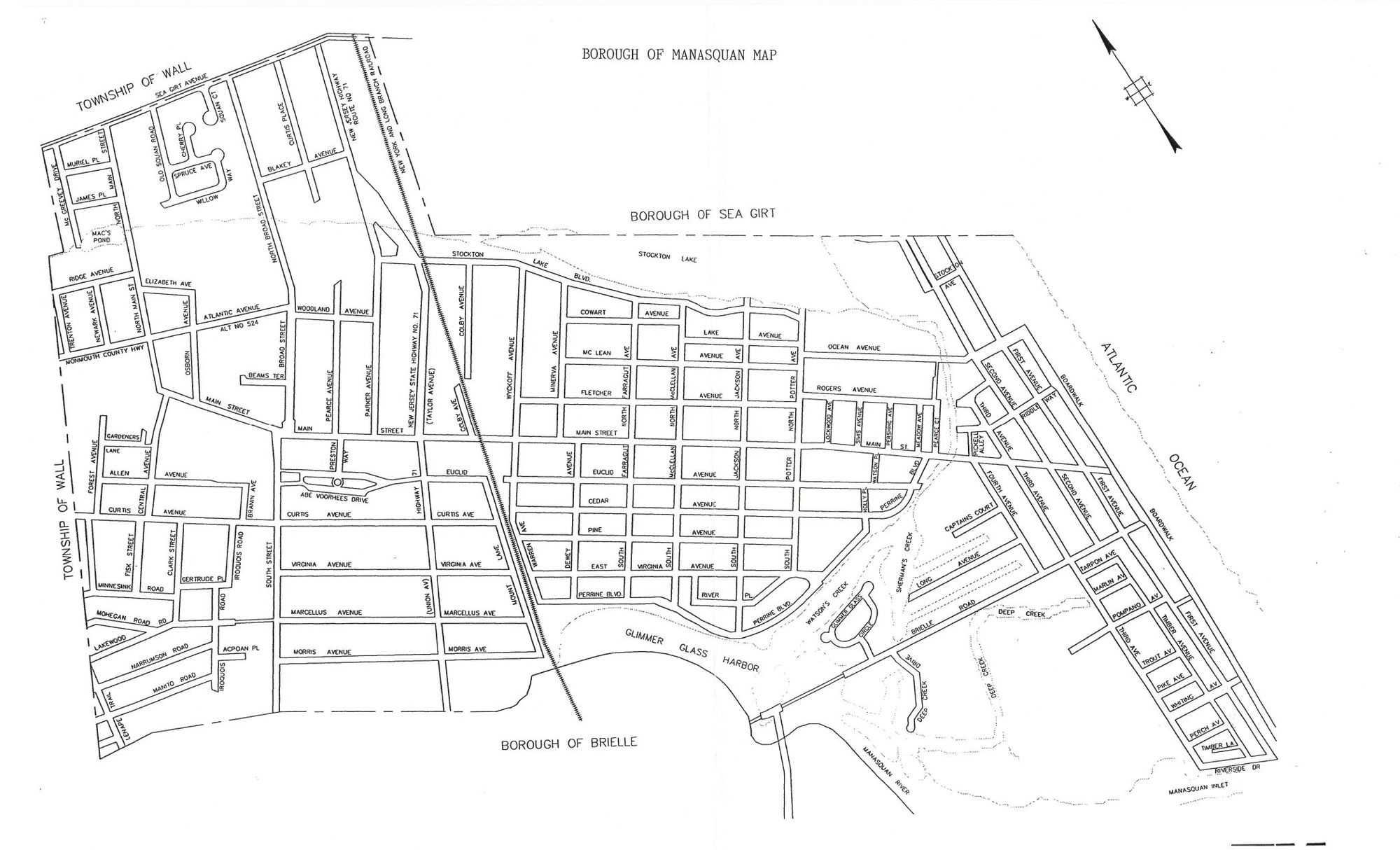

Project Map
Where work is happening around the Borough — tap a pin to open that project.
Latest Updates
September 22, 2026 ·
Schedule updated: Streetscape Segment D (Main Street from Exxon to Train Station; Route 71 limits)
Construction: now Sep 21, 2026 – Dec 15, 2026 (was Mar 1, 2027 – May 31, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment B & C; Segment B (Atlantic Avenue to South Street Plaza); Segment C (Joe Leone's to Exxon)
Construction: now Mar 1, 2027 – May 31, 2027 (was Sep 5, 2027 – Nov 15, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment D (Main Street from Exxon to Train Station; Route 71 limits)
Construction: now Sep 21, 2026 – Dec 15, 2026 (was Mar 1, 2027 – May 31, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment B & C; Segment B (Atlantic Avenue to South Street Plaza); Segment C (Joe Leone's to Exxon)
Design & Permitting: now Aug 31, 2026 – Dec 31, 2026 (was Dec 30, 2025 – Dec 31, 2026)
Construction: now Mar 1, 2027 – May 31, 2027 (was Sep 5, 2027 – Nov 15, 2027)
September 22, 2026 ·
Schedule updated: Axel Carlson Park & Bulkhead Improvements
Design Development: now Jan 1, 2026 – Mar 15, 2026 (was Jan 2, 2026 – Mar 15, 2026)
September 22, 2026 ·
Schedule updated: Fletcher Avenue Phase 1 (N. Potter to N. Farragut)
Design: now Jan 1, 2026 – Jul 1, 2026 (was Jan 5, 2026 – Jul 1, 2026)
September 22, 2026 ·
Schedule updated: Stockton Lake Park Improvements
Design: now Dec 15, 2026 – Feb 13, 2027 (was Sep 22, 2026 – Feb 13, 2027)
September 22, 2026 ·
Schedule updated: Winterstella Park Playground (@Mallard) Improvements
Design Finalization & Permitting: now Nov 1, 2025 – Jun 15, 2026 (was Dec 31, 2025 – Jun 15, 2026)
September 22, 2026 ·
Schedule updated: Streetscape Segment D (Main Street from Exxon to Train Station; Route 71 limits)
Pre-Construction: now Apr 15, 2026 – Sep 21, 2026 (was Dec 30, 2025 – Sep 21, 2026)
Construction: now Sep 21, 2026 – Dec 15, 2026 (was Mar 1, 2027 – May 31, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment D (Main Street from Exxon to Train Station; Route 71 limits)
Construction: now Sep 21, 2026 – Dec 15, 2026 (was Mar 1, 2027 – May 31, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment A & C; Segment A (Atlantic Avenue to South Street Plaza); Segment C (Joe Leone's to Exxon)
Construction: now Mar 1, 2027 – May 31, 2027 (was Sep 5, 2027 – Nov 15, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment A & C; Segment A (Atlantic Avenue to South Street Plaza); Segment C (Joe Leone's to Exxon)
Construction: now Mar 1, 2027 – May 31, 2027 (was Sep 5, 2027 – Nov 15, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment D (Main Street from Exxon to Train Station; Route 71 limits)
Construction: now Sep 21, 2026 – Dec 15, 2026 (was Mar 1, 2027 – May 31, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment A & C; Segment A (Atlantic Avenue to South Street Plaza); Segment C (Joe Leone's to Exxon)
Construction: now Mar 1, 2027 – May 31, 2027 (was Sep 5, 2027 – Nov 15, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment D (Main Street from Exxon to Train Station; Route 71 limits)
Construction: now Sep 21, 2026 – Dec 15, 2026 (was Mar 1, 2027 – May 31, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment A & C; Segment A (Atlantic Avenue to South Street Plaza); Segment C (Joe Leone's to Exxon)
Construction: now Mar 1, 2027 – May 31, 2027 (was Sep 5, 2027 – Nov 15, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment D (Main Street from Exxon to Train Station; Route 71 limits)
Construction: now Sep 21, 2026 – Dec 15, 2026 (was Mar 1, 2027 – May 31, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment D (Main Street from Exxon to Train Station; Route 71 limits)
Construction: now Sep 21, 2026 – Dec 15, 2026 (was Mar 1, 2027 – May 31, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment A & C; Segment A (Atlantic Avenue to South Street Plaza); Segment C (Joe Leone's to Exxon)
Construction: now Mar 1, 2027 – May 31, 2027 (was Sep 5, 2027 – Nov 15, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment A & C; Segment A (Atlantic Avenue to South Street Plaza); Segment C (Joe Leone's to Exxon)
Construction: now Mar 1, 2027 – May 31, 2027 (was Sep 5, 2027 – Nov 15, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment D (Main Street from Exxon to Train Station; Route 71 limits)
Construction: now Sep 21, 2026 – Dec 15, 2026 (was Mar 1, 2027 – May 31, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment A & C; Segment A (Atlantic Avenue to South Street Plaza); Segment C (Joe Leone's to Exxon)
Construction: added (Mar 1, 2027 – May 31, 2027)
Construction: added (Sep 5, 2027 – Nov 15, 2027)
Utility Construction: removed from the schedule
Streetscape Construction: removed from the schedule
September 22, 2026 ·
Schedule updated: Streetscape Segment A & C; Segment A (Atlantic Avenue to South Street Plaza); Segment C (Joe Leone's to Exxon)
Construction: now Mar 1, 2027 – May 31, 2027 (was Sep 5, 2027 – Nov 15, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment D (Main Street from Exxon to Train Station; Route 71 limits)
Construction: now Sep 21, 2026 – Dec 15, 2026 (was Mar 1, 2027 – May 31, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment A & C; Segment A (Atlantic Avenue to South Street Plaza); Segment C (Joe Leone's to Exxon)
Construction: now Mar 1, 2027 – May 31, 2027 (was Sep 5, 2027 – Nov 15, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment D (Main Street from Exxon to Train Station; Route 71 limits)
Construction: now Sep 21, 2026 – Dec 15, 2026 (was Mar 1, 2027 – May 31, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment D (Main Street from Exxon to Train Station; Route 71 limits)
Construction: now Sep 21, 2026 – Dec 15, 2026 (was Mar 1, 2027 – May 31, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment B & C; Segment B (Atlantic Avenue to South Street Plaza); Segment C (Joe Leone's to Exxon)
Construction: now Mar 1, 2027 – May 31, 2027 (was Sep 5, 2027 – Nov 15, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment A & C; Segment A (Atlantic Avenue to South Street Plaza); Segment C (Joe Leone's to Exxon)
Construction: now Mar 1, 2027 – May 31, 2027 (was Sep 5, 2027 – Nov 15, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment D (Main Street from Exxon to Train Station; Route 71 limits)
Construction: now Sep 21, 2026 – Dec 15, 2026 (was Mar 1, 2027 – May 31, 2027)
September 22, 2026 ·
Schedule updated: Axel Carlson Park & Bulkhead Improvements
Design Development: now Jan 1, 2026 – Mar 15, 2026 (was Dec 1, 2025 – Mar 15, 2026)
September 22, 2026 ·
Schedule updated: Streetscape Segment A-2: Monmouth County Roundabout Project
Design: now Nov 17, 2025 – Sep 21, 2026 (was Nov 1, 2025 – Sep 21, 2026)
September 22, 2026 ·
Schedule updated: Streetscape Segment B & C; Segment B (Atlantic Avenue to South Street Plaza); Segment C (Joe Leone's to Exxon)
Construction: now Mar 1, 2027 – May 31, 2027 (was Sep 5, 2027 – Nov 15, 2027)
September 22, 2026 ·
Schedule updated: Streetscape Segment A-1 Underground Utility Work: South Street Plaza to Joe Leone's; Broad Street; South Street
Design: now Nov 12, 2025 – Apr 1, 2026 (was Dec 1, 2025 – Apr 1, 2026)
September 22, 2026 ·
Schedule updated: Streetscape Segment D (Main Street from Exxon to Train Station; Route 71 limits)
Construction: now Sep 21, 2026 – Dec 15, 2026 (was Mar 1, 2027 – May 31, 2027)
September 21, 2026 ·
Schedule updated: Main St / Route 71: Streetscape (TAP Grant)
Pre-Construction: now Apr 15, 2026 – Sep 21, 2026 (was Apr 15, 2026 – Sep 6, 2026)
Seasonal Shutdown: added (Dec 15, 2026 – Feb 28, 2027)
Construction: now Mar 1, 2027 – May 31, 2027 (was Sep 21, 2026 – Dec 15, 2026)
September 21, 2026 ·
Schedule updated: Main St / Route 71: Streetscape (TAP Grant)
Construction: now Sep 21, 2026 – Dec 15, 2026 (was Mar 1, 2027 – May 31, 2027)
September 21, 2026 ·
Schedule updated: Main St Between Broad St. and 71 Downtown: Streetscape & Utilities
Design & Permitting: added (Aug 31, 2026 – Dec 31, 2026)
Bidding & Award: now Jan 1, 2027 – Feb 1, 2027 (was Nov 2, 2026 – Dec 7, 2026)
Pre-Con and Shop Drawings: now Feb 1, 2027 – Feb 28, 2027 (was Dec 8, 2026 – Jan 18, 2027)
Utility Construction: now Mar 1, 2027 – May 31, 2027 (was Jan 18, 2027 – Mar 14, 2027)
Streetscape Construction: now Sep 5, 2027 – Nov 15, 2027 (was Sep 5, 2027 – Nov 1, 2027)
Design: removed from the schedule
September 21, 2026 ·
Schedule updated: Stockton Lake Bulkhead & Axel Carlson Park Improvements
NJDEP/NJDOT/SCD/Green Acres Approval: added (Mar 15, 2026 – Dec 31, 2026)
Bidding: now Jan 1, 2027 – Jan 31, 2027 (was Nov 23, 2026 – Dec 21, 2026)
Pre-Construction & Shop Drawings: now Feb 1, 2027 – Feb 28, 2027 (was Dec 21, 2026 – Jan 25, 2027)
Construction: now Mar 1, 2027 – Aug 31, 2027 (was Jan 25, 2027 – Aug 31, 2027)
NJDEP/NJDOT/SCD Permit Approval: removed from the schedule
September 21, 2026 ·
Schedule updated: Main St Roundabout: County Rebuild
Design: added (Nov 1, 2025 – Sep 21, 2026)
Bidding: added (Sep 21, 2026 – Nov 1, 2026)
Award: added (Nov 1, 2026 – Nov 30, 2026)
Pre-Construction : added (Nov 30, 2026 – Dec 31, 2026)
Construction : added (Jan 1, 2027 – May 31, 2027)
Design, Bidding, Award: removed from the schedule
Award & Pre-Construction: removed from the schedule
Construction Phase 1: removed from the schedule
Seasonal Shutdown: removed from the schedule
Construction Phase 2: removed from the schedule
Construction Phase 3: removed from the schedule
September 21, 2026 ·
Schedule updated: Fletcher Avenue Phase 1 (N. Potter to N. Farragut)
Utility Construction & Concrete (Sidewalk, Curb) Improvements: added (Oct 1, 2026 – Dec 15, 2026)
Seasonal Shutdown: now Dec 15, 2026 – Mar 1, 2027 (was Dec 15, 2026 – Mar 15, 2027)
Roadway Construction (Remaining Concrete, Paving): now Mar 1, 2027 – Apr 30, 2027 (was Mar 15, 2027 – Apr 30, 2027)
Utility Construction & Sidewalk Improvements: removed from the schedule
September 21, 2026 ·
Schedule updated: Winterstella (Mallard) Park Improvements
Bidding & Award: now Jun 15, 2026 – Aug 31, 2026 (was Jun 15, 2026 – Sep 21, 2026)
Pre-Construction (Shop Drawings, Fabrication): added (Aug 31, 2026 – Feb 1, 2027)
Pre-Con & Shop Drawings: removed from the schedule
Winter Shutdown: removed from the schedule
September 21, 2026 ·
New project: Stockton Lake Boulevard Bulkhead Project
The Borough is undertaking a project to install a new bulkhead along Stockton Lake Boulevard within the Borough Right of Way from North Mcclellan Avenue to North Potter Avenue to improve shoreline stability and help protect adjacent public infrastructure from tidal impacts. The project will include the construction of a new waterfront retaining structure, associated drainage improvements, and restoration of disturbed areas. This investment will enhance the resilience of the shoreline, improve long-term maintenance conditions, and help preserve public access and community assets along the waterfront corridor. Location: Stockton Lake Boulevard. Scheduled May 1, 2026 – Dec 1, 2026.
September 21, 2026 ·
Schedule updated: First Avenue Phase III & Riverside Drive
Roadway Construction (Remaining Concrete, Paving): now Sep 15, 2026 – Sep 30, 2026 (was Sep 21, 2026 – Sep 30, 2026)
September 21, 2026 ·
Schedule updated: Stockton Lake Park Improvements
Permitting: added (Feb 13, 2027 – May 14, 2027)
NJDEP Permit Approval: removed from the schedule
September 11, 2026 ·
Schedule updated: Main St Roundabout: County Rebuild
Award & Pre-Construction: now Oct 22, 2026 – Nov 12, 2026 (was Nov 12, 2026 – Dec 31, 2026)
Seasonal Shutdown: now Nov 15, 2026 – Dec 31, 2026 (was Oct 1, 2026 – Dec 31, 2026)
September 11, 2026 ·
Schedule updated: Winterstella (Mallard) Park Improvements
Bidding & Award: now Jun 15, 2026 – Sep 21, 2026 (was Jun 15, 2026 – Aug 17, 2026)
Pre-Con & Shop Drawings: now Sep 22, 2026 – Nov 15, 2026 (was Aug 17, 2026 – Nov 15, 2026)
September 11, 2026 ·
Schedule updated: Municipal Building Exterior Improvements
Construction: now Mar 19, 2026 – Oct 23, 2026 (was Mar 19, 2026 – Sep 19, 2026)
September 11, 2026 ·
Schedule updated: First Avenue Phase III & Riverside Drive
Roadway Construction (Remaining Concrete, Paving): now Sep 21, 2026 – Sep 30, 2026 (was Sep 15, 2026 – Dec 15, 2026)
September 11, 2026 ·
Schedule updated: Main St / Route 71: Streetscape (TAP Grant)
Construction: now Sep 21, 2026 – Dec 15, 2026 (was Sep 14, 2026 – Dec 15, 2026)
August 5, 2026 ·
Schedule updated: Stockton Lake Bulkhead Improvements
NJDEP/NJDOT/SCD Permit Approval: added (Mar 15, 2026 – Nov 23, 2026)
Bidding: now Nov 23, 2026 – Dec 21, 2026 (was Aug 15, 2026 – Sep 15, 2026)
Pre-Construction & Shop Drawings: now Dec 21, 2026 – Jan 25, 2027 (was Sep 15, 2026 – Oct 18, 2026)
Construction: now Jan 25, 2027 – Aug 31, 2027 (was Oct 19, 2026 – Mar 15, 2027)
NJDEP Permit Approval: removed from the schedule
August 5, 2026 ·
Schedule updated: Municipal Building Exterior Improvements
Construction: now Mar 19, 2026 – Aug 31, 2026 (was Mar 19, 2026 – Jul 31, 2026)
August 5, 2026 ·
Schedule updated: Fletcher Avenue Phase 1
Bidding: now Jul 1, 2026 – Aug 31, 2026 (was Jul 1, 2026 – Aug 1, 2026)
Award & Pre-Construction: now Sep 1, 2026 – Sep 30, 2026 (was Aug 1, 2026 – Sep 1, 2026)
Utility Construction & Sidewalk Improvements: now Oct 1, 2026 – Dec 15, 2026 (was Sep 1, 2026 – Dec 15, 2026)
July 21, 2026
Welcome to Manasquan Projects Central
This page tracks every active capital improvement project in the Borough — what's happening, where, and when. Schedules are updated as projects move forward.

With Thanks to the Borough Council
Every project on this page is authorized by the Manasquan Borough Council through the Borough's capital plan — getting as much done as possible while living within our budget. The Council's standard for fiscal responsibility and transparency is the reason this site exists.
Jay Bryant
Council President
Bruce Bresnahan
Council Member
Brian Holly
Council Member
Gregg Olivera
Council Member
Lori Triggiano
Council Member
Sheila Vidreiro
Council Member
QUESTIONS ABOUT A PROJECT?
Ask the Mayor and the project team directly — your question goes straight to us and we’ll get back to you.
